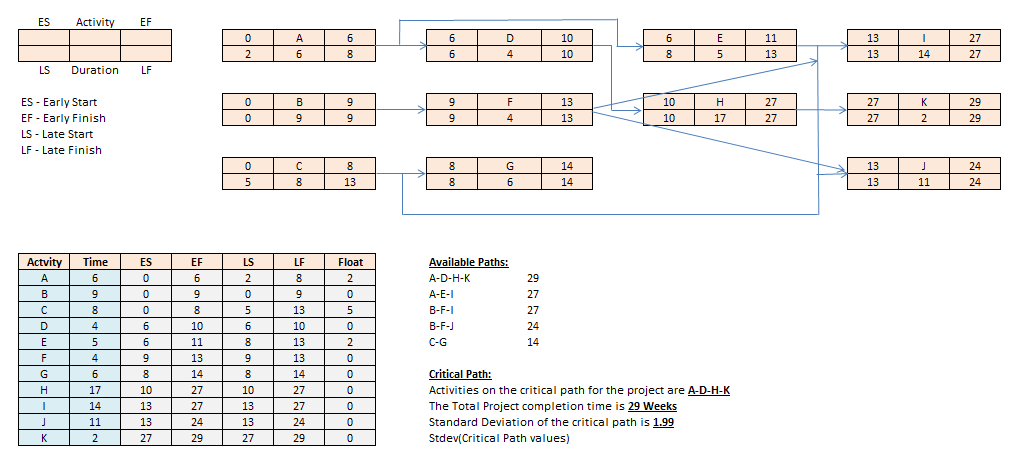

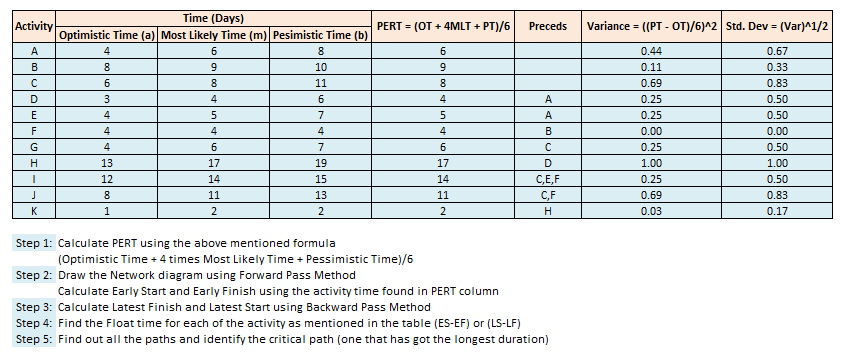

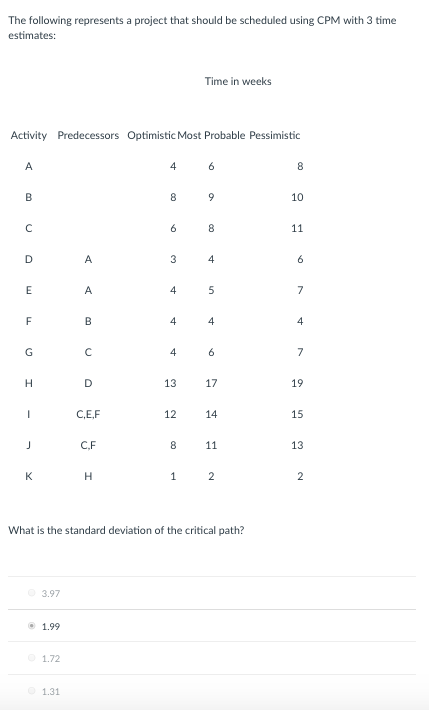

The following represents a project that should be scheduled using CPM with 3 time estimates: Time in weeks What is the standard deviation of the critical path? 3.97 1.99 1.72 1.31
Question & Answer: The following represents a project that should be scheduled using CPM with 3 time estimates:…..
the following represents a project that should be scheduled using cpm:
Could you show work too please? Thanks!
Expert Answer
The Standard deviation of the critical path is found to be 1.99
Note: Since I created this as a table in a spreadsheet, took a screenshot from the excel. Directly viewing the answer might not be clear. To view this answer clearly, right click on the answer image and save it to your desktop, so they are very clear and legible…
